USM Content
Learn how to set and manage baselines in Smartsheet to track project progress and variances. Discover how to track your project’s critical path to ensure timely completion.
Set baselines on a sheet
USM Content
When you activate baselines, three non-editable columns appear on the sheet, in addition to your actual start date and end date columns:
- Baseline Start: The date in your start date column.
- Baseline Finish: The date in your end date column.
- Variance: The difference between the actual end date and the baseline end date.
Only sheet Owners or Admins can create and edit baselines. Anyone else who has been shared to the sheet can view baselines.
Keep in mind:
- You can only add one baseline to a project sheet. If multiple start date and end date columns exist, you can only associate one set of start date and end date columns with baselines.
- You can't add a baseline to a row without specifying both a start and an end date, or to a row with a start date that precedes the end date. The cell data must also be in an acceptable date format. For example, TBD or July don't work.
- The activity log doesn’t track historical baseline modifications, but they can be found in the cell history.
- Baselines appear as read-only data in cells. Consequently, baselines are displayed in reports, dashboards, and other Smartsheet items, but you can’t modify them.
- You can convert the baseline columns to date (baseline start and baseline finish) and text/number (variance) columns, and the cell data remains unchanged.
Set up your sheet to use baselines
To enable baselines on your sheet:
- Add start date and end date columns
- Switch to Gantt View, then select the Baselines button in the toolbar. The baseline summary displays the actual and baseline start and end dates, along with the variance.
- To activate, select the Set button.
Edit baselines in the baselines summary
Once enabled on your project sheet, you can use the baseline summary to view, edit, and remove baseline information.
To open the baseline summary, go to Gantt view, and select the Baselines button in the toolbar.
Show baseline in Gantt
Toggle for enabling baseline in Gantt view.
You can see visual Gantt bars for baseline and actual dates. If you change your preferences to display or hide baseline bars in the Gantt view, the change only affects your user and doesn't impact other users.
Although the Baseline Start, Baseline Finish, and Variance columns are visible in a report, baseline bars from the Gantt view don't show in either reports or dashboard widget reports. Additionally, baselines aren't displayed when you print your Gantt view.
Actual
The earliest actual start and the latest actual end date in your columns.
Baseline
The earliest baseline start date and the latest baseline end date in your columns. These were established when you initially activated the baseline and can’t be modified.
Variance
The difference between the actual and baseline end dates is calculated in decimal days according to the working schedule defined for your project. Variance displays the overall status of your project as days behind, days ahead, or on schedule. As dates change on your sheet, they are updated automatically. Updating actual project dates triggers the recalculation of the variance column.
Reset
Establish a new baseline start and end date. This resets the variances to zero and sets the values in the baseline columns to the current values in the actual start and end date columns. This creates a new snapshot of project dates, and the variance displays as on schedule.
Remove
Remove the baseline from your sheet. This removes the baselines but doesn't delete the Baseline Start, Baseline Finish, and Variance columns.
Track the critical path in a sheet
USM Content
As task dates or inter-task dependencies change, the sheet’s critical path can be impacted. Smartsheet automatically updates and highlights the tasks on the current critical path.
Only paid users who are sheet Owners or Admins can enable dependencies in Project Settings to display the critical path. Anyone with Editor or higher-level permissions can display or hide the critical path.
What is the critical path?
The critical path is the longest sequence of tasks (from start to finish) that must be completed on time to stay on schedule and avoid project delays. It's determined using task start dates, end dates, duration, and dependencies (task predecessors).

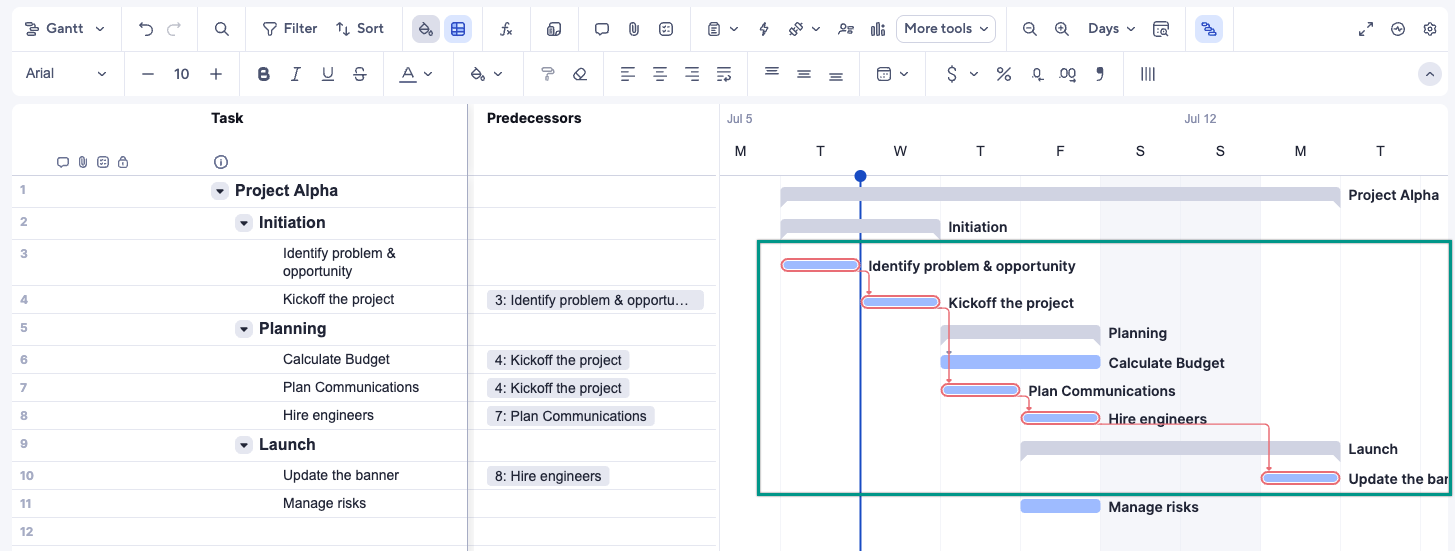

All tasks and milestones that comprise a project's critical path are highlighted in red in the Gantt view.
Set up a sheet to display the critical path
To use a critical path, your sheet must be in Gantt view.
- Select the Edit Sheet Settings icon
in the top right corner of the sheet, and set Dependencies to activated.Brandfolder Image
- In your sheet, assign each task a start date, and an end date or duration.
- For each task that depends on another task, assign that other task as a predecessor.
- To show your project's critical path, select the Show Critical Path icon in the upper-right corner of the sheet.
Tips and troubleshooting
- The critical path appears on child rows. If the rows are collapsed and you want to view the child rows, right-select the primary column and select Expand All.
- If you want to show only rows on the critical path, apply a filter for that condition. Refer to the image below as an example of a filter to show critical path rows.
